Snowflake DCM Projects

Snowflake DCM Projects (Database Change Management) enable a declarative approach to managing Snowflake objects as code. You define the desired target state of your databases, schemas, tables, and other objects in definition files, and Snowflake determines and applies the necessary changes to reach that state. This enables version-controlled, repeatable deployments across environments, such as dev, staging, and production, using a plan-then-deploy workflow common among infrastructure-as-code tools.

You can author, debug, and deploy DCM Projects by hand in Snowflake Workspaces or your local IDE, use Cortex Code to do it via natural-language prompts, or automate deployments through CI/CD pipelines. See Interfaces and How to get started for details.

If your definitions contain repetitive patterns, you can parameterize your code by using Jinja templating, including dictionaries, loops, conditions, and macros.

The high-level workflow for managing a DCM project is as follows:

  1. Create DCM project files (manifest.yml and SQL definition files) in a Snowflake Workspace, remote Git repository, or local directory.

  2. Create a new DCM project for each target environment.

  3. Define Snowflake objects in the DCM project files.

    Convert your existing SQL deployment scripts by using the DEFINE keyword (for supported object types).

  4. (Optional) Add shared or alternative templating variables and macros.

  5. Execute a DCM PLAN command to mimic a deployment and preview the changes.

  6. Deploy the project version to apply changes in Snowflake.

  7. Monitor project executions.

  8. Iterate on your DCM project. Update the project files, review the plan output, and deploy new versions as needed.

This lifecycle helps you build, test, deploy, and monitor database changes in a controlled, versioned, and auditable way.

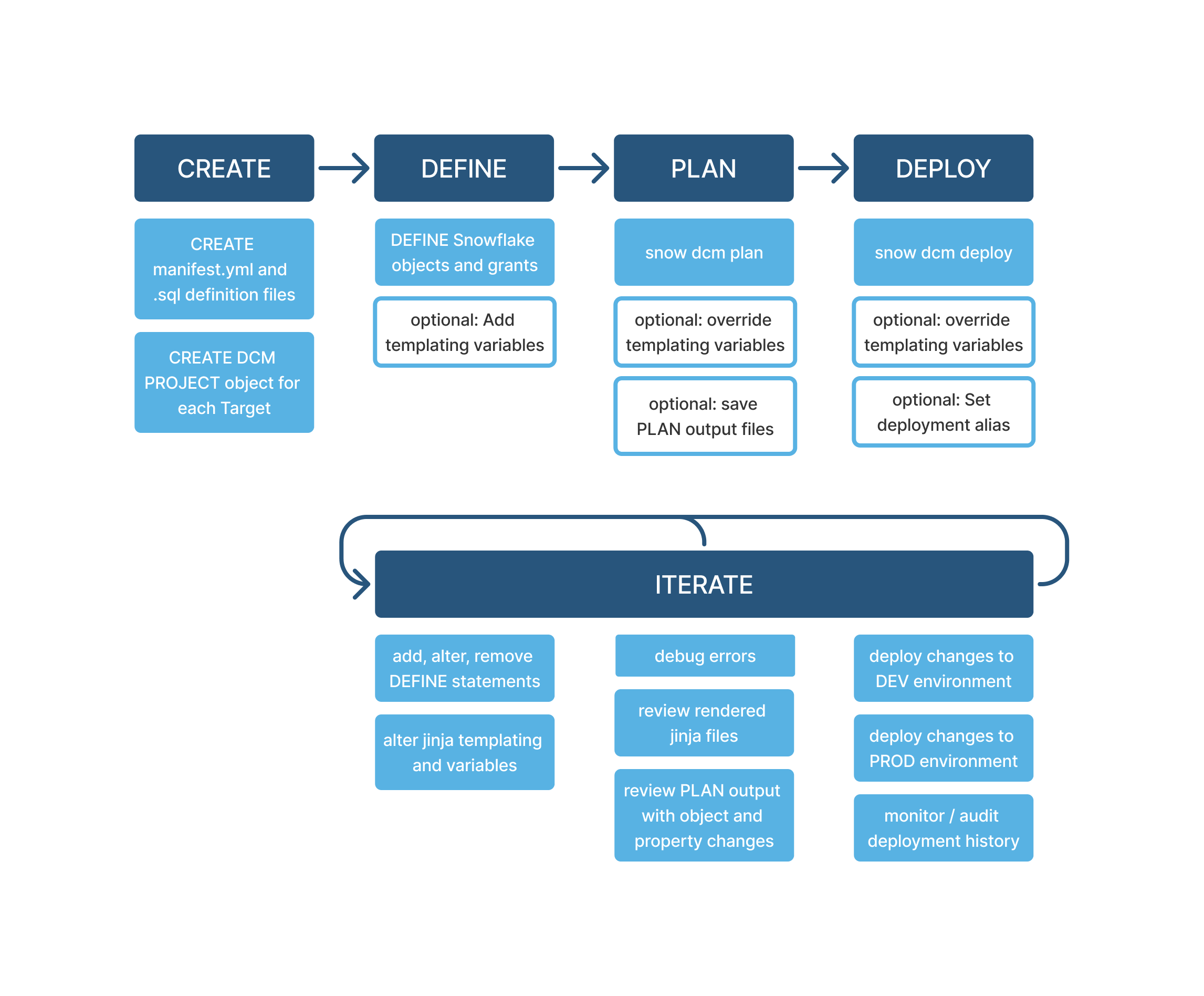

The following diagram illustrates the DCM Projects lifecycle outlined above.

DCM Project Lifecycle

Interfaces

You can work with DCM Projects using Snowsight Workspaces, Snowflake CLI in your local IDE, natural-language prompts with Cortex Code, SQL commands, or an automated CI/CD pipeline. For a comparison of these interfaces, setup instructions, and a diagram of how they fit into a typical development-to-production workflow, see Interface tools in Create and deploy DCM Projects.

How to get started

You can get started with a DCM project in one of the following ways. Cortex Code can assist you with any of these paths:

  • Try the quickstart: Clone a demo project from the Snowflake Labs repository and let a guided quickstart walk you through the steps.
  • Start a new project: Create a new, empty DCM project in a Snowsight Workspace.
  • Bring an existing project: Clone a Git repository containing an existing DCM project into a Workspace or local environment to modify, test, and deploy it.
  • Migrate existing infrastructure: Convert your existing account infrastructure or custom SQL scripts into a DCM project using the migration stored procedure or Cortex Code skill. See Migrating existing objects to DCM Projects below.

For setup instructions and interface-specific steps, see Create and deploy DCM Projects.

Try the quickstart

The Get Started with Snowflake DCM Projects quickstart walks through a sample food truck analytics pipeline and covers:

  • Creating a Snowflake Workspace linked to the Snowflake Labs DCM repository
  • Setting up a dedicated role and a DCM project object
  • Exploring a project’s manifest file, definition files, and Jinja macros
  • Running PLAN and DEPLOY to create the pipeline
  • Attaching data quality expectations with data metric functions

Migrating existing objects to DCM Projects

Note

The migration skill and stored procedure are provided as experimental tools. Test them thoroughly and use them at your own risk.

If you already have Snowflake objects that you want to bring under DCM Projects management, use the migration tools in the migration-tools folder of the Snowflake Labs DCM repository. Both tools generate DEFINE statements for your existing objects by running GET_DDL against a database or schema you select:

  • Cortex Code skill: Guides you through the full migration workflow. It runs the stored procedure to generate DEFINE files, runs PLAN to compare them against the live objects, helps you refine the DEFINE statements based on the diff, runs DEPLOY with zero changes to adopt the objects into DCM Projects, and can optionally identify Jinja templating opportunities for multi-environment setups. Cortex Code pauses at key checkpoints for your review and approval.
  • Stored procedure: A fallback for when Cortex Code isn’t available. It only covers the file generation step; you set up the DCM project, and run PLAN and DEPLOY manually afterward.

If another role already owns an object, the DCM project owner role must hold that role. Snowflake recommends including a GRANT OWNERSHIP statement that grants ownership of the object to the same role. See Ownership on DCM-managed objects.

Key terms

The following are the key terms you should know when working with DCM Projects.

Declarative definitions

In DCM Projects, you define the desired state of your Snowflake environment, such as which tables, schemas, or roles should exist, independent of the current state of the objects. You do not specify each step to create or modify them. You describe what you want, and Snowflake figures out how to make it happen.

Specifically, DCM Projects leverage DEFINE statements with templating features. This makes project files reusable and customizable for different environments. The order and location of DEFINE statements within a project don’t affect the results. Snowflake collects and sorts all statements before applying changes, so you don’t need to manually handle sequencing or dependencies.

DCM project files

A DCM project is based on a set of SQL and YAML source files, usually managed in a Git repository or your local workspace. You define Snowflake objects, their attributes, relationships, and constraints for a DCM project in your project definition files (SQL files). You update your project files in a development workspace. Changes only take effect in Snowflake after you deploy them through a DCM project object.

DCM project object

A DCM project is a schema-level object in Snowflake that you use to deploy and manage the objects defined in DCM project files. You need a DCM project object for each target environment.

The DCM project object is used to execute DCM commands and stores the immutable artifacts and definition files of all executed deployments.

Though a DCM project is a schema-level object, you can use it to create and manage objects in other databases. You can also execute a DCM project to perform a dry run of changes to your workflow so that you can preview changes before deploying them.

Requirements

  • Use Snowsight, Snowflake CLI, SQL, or Cortex CLI to manage DCM Projects.
  • You need a database and a schema where you can create your DCM project objects.
  • Store your DCM project definitions locally or in Snowflake Workspace.
  • Use Git for collaboration, versioning, and for synchronizing changes.
  • If you want to execute local definitions using Snowflake CLI, you also need privileges to create a temporary stage in the schema of your target DCM project object.

Cost

DCM Projects are available for all Snowflake editions. There are no DCM Projects-specific costs beyond the compute cost incurred by DCM Projects operations.

DCM Projects operations such as PLAN and DEPLOY are primarily metadata operations and incur Cloud Services compute cost, similar to running DDL scripts with ALTER or CREATE statements. Warehouse compute cost can also apply, for example when rendering Jinja templates or when querying DCM Projects deployment history in Information Schema.

In Snowsight Workspaces, the DCM ANALYZE command only runs in the background while you’re actively editing a project’s definition files.

Warehouse size doesn’t affect the latency of DCM Projects execution. An X-Small warehouse is sufficient.

Considerations and limitations

Project size and performance

Note

The execution time of PLAN and DEPLOY depends on both the size and the shape of the project definitions. The dependency depth across objects, grants, and attachments can affect execution time more than the number of defined or modified entities alone. For example, grants on dynamic tables that call functions to read from views that join external source tables take longer to evaluate than a large number of independent tables.

As a reference point, PLAN or DEPLOY for projects with 1,000+ entities can take 10 minutes or more. A smaller project with deep dependencies can take longer than a larger project with mostly independent entities. Consolidating definitions into fewer files generally shows faster execution times for PLAN and DEPLOY commands.

Currently, DCM Projects supports up to 10,000 defined entities, grants, or attachments per project, with a maximum total size of 30 MB. This 30 MB limit applies to both the sum of all source files and the rendered definition files. In some cases, exceeding these limits can cause executions to fail due to timeouts.

DCM Projects also supports up to 10,000 files under /sources in a project.

If a large project contains segments with no interdependencies, such as separate business units or applications, consider splitting it into multiple smaller projects along those boundaries. This can improve PLAN and DEPLOY execution times. For options and recommendations, see Architectural recommendations for DCM Projects.

To validate definition changes faster during active development, use PLAN DELTA to evaluate only the definitions you changed instead of the entire project.

Changeset

Both PLAN and DEPLOY commands list all DDL changes inside the plan_result.json file. The changeset lists the operations performed or planned (CREATE, ALTER, DROP) and the individual attributes affected, such as comment, schedule, and timeout.

Note

For object types, grants, and attachments still in preview, the completeness of the changeset in plan_result.json and deploy_result.json isn’t guaranteed yet, and the changeset format can still change.

Templating

  • Because definition files are Jinja2 templates, all of the limitations for Jinja2 templates apply.
  • DCM templating variables are not intended for sensitive information like credentials. The rendered SQL definitions don’t redact any values inserted by environment variables.

Key use cases for DCM Projects

This section describes key use cases for DCM Projects and how they help address challenges that data businesses face at scale. For all of these use cases, Cortex Code can author and iterate on the definitions, and you review the PLAN output before you deploy.

DCM Projects for managing infrastructure

DCM Projects help address the following challenges that platform teams often encounter:

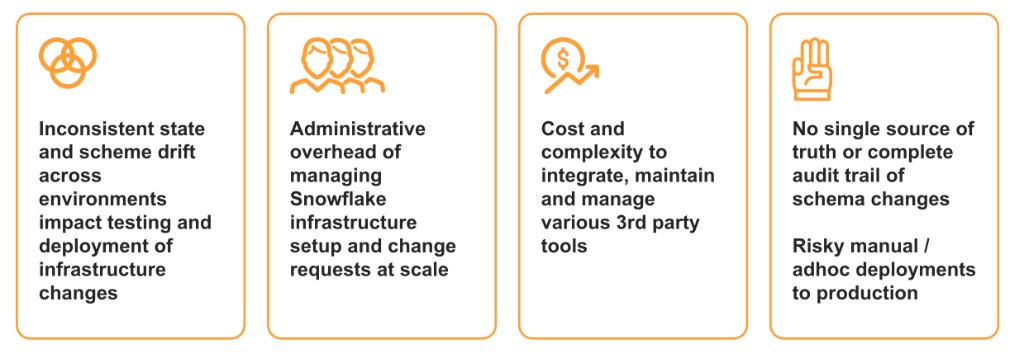

Challenges for platform teams

When platform teams want to deploy and maintain standardized infrastructure for multiple business units, they can use DCM Projects to define a standard set of objects in code as SQL files. And with Jinja, this template can be parameterized, for example, by team name, and deployed multiple times.

Example: Create a dedicated DCM project for each business unit

One approach is to create a dedicated DCM project for each business unit, with all projects referencing the same parameterized definition files, as shown in the following definitions.sql example:

DEFINE DATABASE {{team_name}}_DB;

DEFINE ROLE {{team_name}}_ADMIN;

DEFINE WAREHOUSE {{team_name}}_WH WITH
  warehouse_size = '{{wh_size}}'
  auto_suspend = 300;

GRANT OWNERSHIP ON DATABASE {{team_name}}_DB TO ROLE {{team_name}}_ADMIN;

GRANT OWNERSHIP ON WAREHOUSE {{team_name}}_WH TO ROLE {{team_name}}_ADMIN;

GRANT ROLE {{team_name}}_ADMIN TO ROLE SYSADMIN;

Execute the DCM project with the following command:

EXECUTE DCM PROJECT FINANCE_INFRA PLAN
  USING (team_name => 'Finance', wh_size => 'LARGE')
FROM
  ...

Example: Create a single DCM project for multiple business units

In this approach, you manage infrastructure for multiple business units in one DCM project by using loops in your Jinja template, as shown in the following definitions.sql example:

{% for team_name in teams %}

  DEFINE DATABASE {{team_name}}_DB;
  DEFINE ROLE {{team_name}}_ADMIN;
  DEFINE WAREHOUSE {{team_name}}_WH
    WITH
      warehouse_size = '{{wh_size}}'
      auto_suspend = 300;

  GRANT OWNERSHIP ON DATABASE {{team_name}}_DB TO ROLE {{team_name}}_ADMIN;
  GRANT OWNERSHIP ON WAREHOUSE {{team_name}}_WH TO ROLE {{team_name}}_ADMIN;
  GRANT ROLE {{team_name}}_ADMIN TO ROLE SYSADMIN;

{% endfor %}

Execute the DCM project with the following command:

EXECUTE DCM PROJECT FINANCE_INFRA PLAN
  USING (teams => ['Finance', 'HR', 'Engineering'], wh_size => 'MEDIUM')
FROM
  ...

This makes it easy for platform teams and admins to make changes such as:

  • Add a new team to the list to deploy the existing infrastructure template for that team.
  • Remove a team from the list to drop the infrastructure of that team.
  • Add a new READ_ONLY role for all teams.
  • Change specific configurations such as grants or warehouse size across all teams or for a specific team.
  • Run PLAN to compare the current state against expected standards and re-deploy to reinstate standards.

DCM Projects for data pipelines

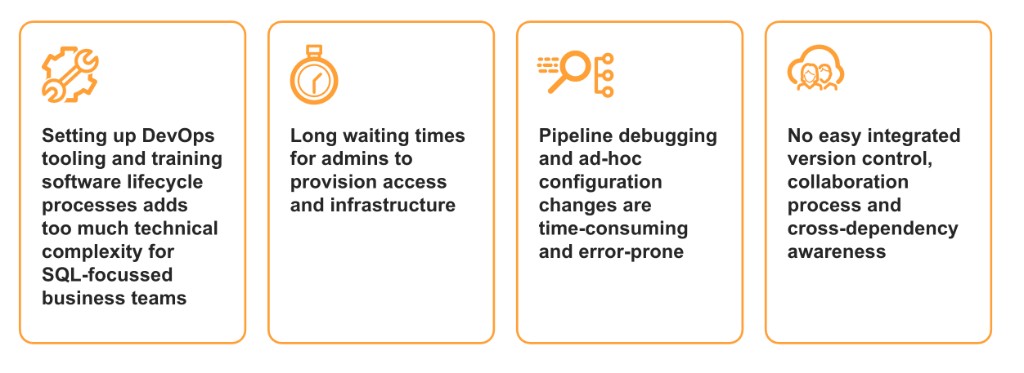

Feature teams can use DCM Projects to define, test, deploy, and iterate over the business logic of their data pipelines. A single DCM project can combine pipes, streams, dynamic tables, views, and the tasks that orchestrate procedures, Code Bundles, and dbt projects. For the challenges that DCM Projects address for feature teams, the pipeline-specific commands, and how DCM Projects relate to Pipeline Builder, see DCM Projects for data pipelines.

DCM Projects for data governance

DCM Projects help platform and security teams manage access and track changes to their accounts:

  • Declarative privilege management: Define roles, database roles, and grants as code, and use Jinja templates to apply the same privilege structure across schemas, databases, and teams. Removing a grant that DCM Projects deployed from the definitions revokes it on the next deployment. Grants added outside of DCM Projects aren’t removed. See Grants.
  • Audit trail: Each deployment stores the applied definitions, configuration, and changes as immutable artifacts in the DCM project. See Monitor and troubleshoot DCM Projects.
  • Drift detection: Run PLAN against the current account state to identify changes made outside of DCM Projects, and redeploy to reinstate the defined state. See Monitor and troubleshoot DCM Projects.
  • Separation of concerns: Assign different projects to different owner roles, for example one project for roles and grants and another for databases and warehouses.

DCM Projects for applications and the semantic layer

You can deploy applications and the semantic layer together with the tables, views, and grants that they depend on:

  • Semantic views: Define semantic views on top of the tables and views in the same project, and deploy them to each environment with the rest of the pipeline.
  • Streamlit apps (preview): Reference an existing Streamlit app folder as a project asset and define the Streamlit app in the same project. DCM Projects deploys a new version only when the app’s files change.
