Create and deploy DCM Projects

This topic describes how to create and deploy DCM Projects to manage Snowflake environments, including accounts.

The DCM project lifecycle involves the following steps:

  1. Prepare your Snowflake account for a DCM project.
  2. Define project configuration and objects in project files.
  3. Create a DCM Projects object.
  4. Plan to preview proposed changes before deployment.
  5. Deploy the project.
  6. Monitor deployments and troubleshoot failing plans.
  7. Manage the deployed project and the entities, grants, and attachments it manages.

You can continuously deploy incremental changes to your project as well as large-scale account infrastructure changes.

Prepare for a DCM project

To get started with DCM Projects, your Snowflake account must satisfy the following prerequisites:

  • A database and schema where you can create your DCM Projects object
  • A role with privileges to create a DCM Projects object and access to run queries on a warehouse
  • For Snowflake CLI, a role with privileges to create a temporary stage

This section describes the tasks that you need to complete to prepare for DCM Projects:

Interface tools

You have the following interface options available for DCM Projects.

Interface toolBest for

Snowsight

A workspace in Snowsight is a Snowflake native cloud IDE in your account.

  • Easily create or upload DCM definition files via the UI.
  • Connect to a Git repository to pull and push changes.
  • Review, edit, and debug definition files.
  • Execute DCM PLAN and DEPLOY commands using the workspace UI.
  • Browse the database catalog to see DCM project objects and their configuration, managed objects, and deployment history.
  • Select a target profile to automatically use the linked DCM project and templating configuration.

Local IDE with Snowflake CLI

The most familiar and personalized interface for software engineers.

  • Create and edit definition files locally.
  • Connect to a Git repository to pull and push changes.
  • Concise Snowflake CLI commands with directory context and optional flags.
  • Rich formatted output and an option to save as a .json file.
  • Option to leverage Cortex Code CLI for agentic or assisted development.
  • See Snowflake CLI for DCM Projects for information about installing and running Snowflake CLI in your local IDE.

Cortex Code

An agentic AI tool for Snowflake. See Cortex Code for DCM Projects for more information.

  • AI assisted or agentic authoring of local definition files.
  • AI assisted or agentic code validation and debugging by running static analysis and DCM PLAN commands.
SQL commands
  • Run SQL commands from the Snowflake CLI REPL, workspaces, notebooks, or worksheets.
  • Customize commands with additional arguments.
  • Same commands work across all Snowflake SQL interfaces.

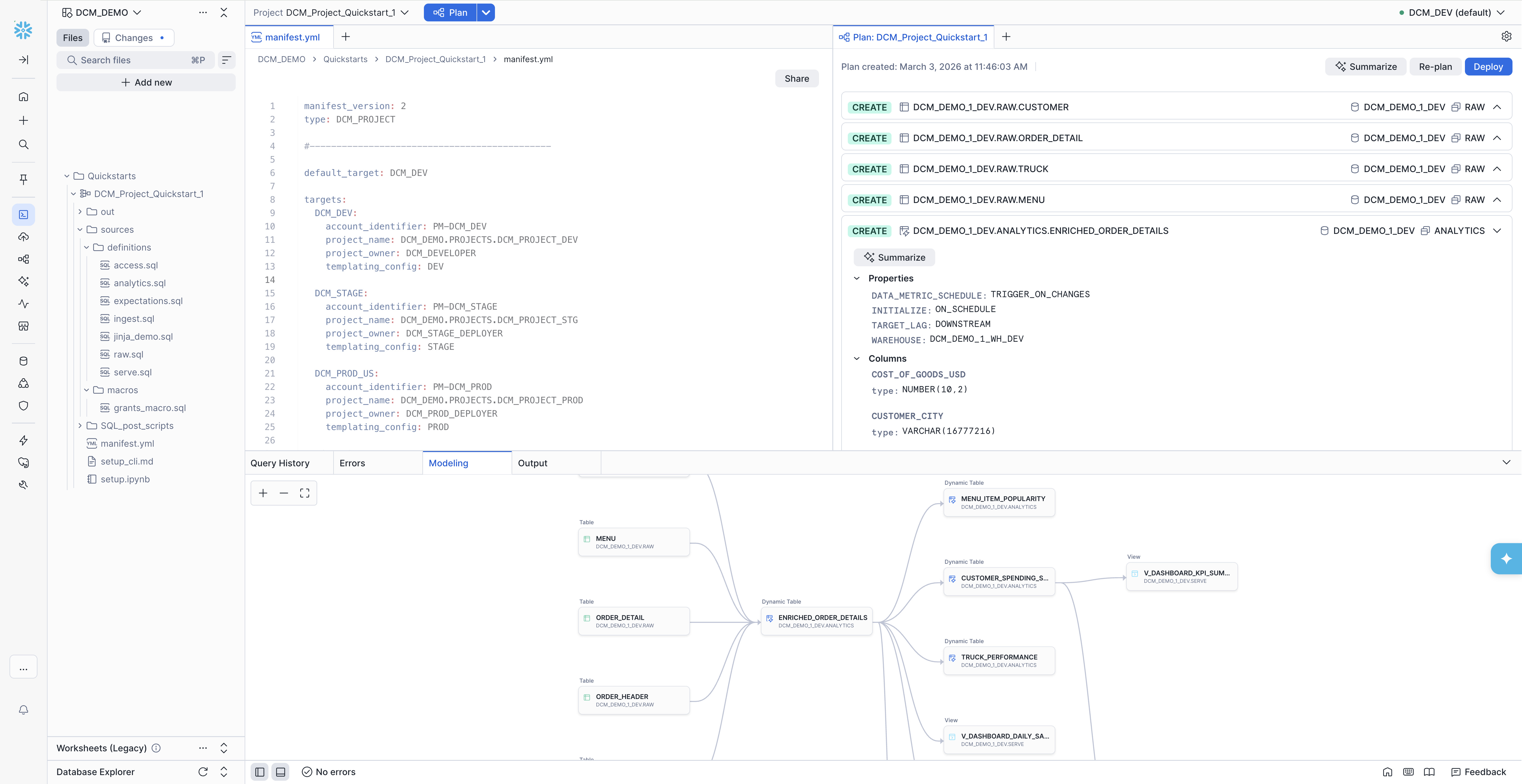

The following diagram shows how these interfaces fit into a typical development-to-production workflow.

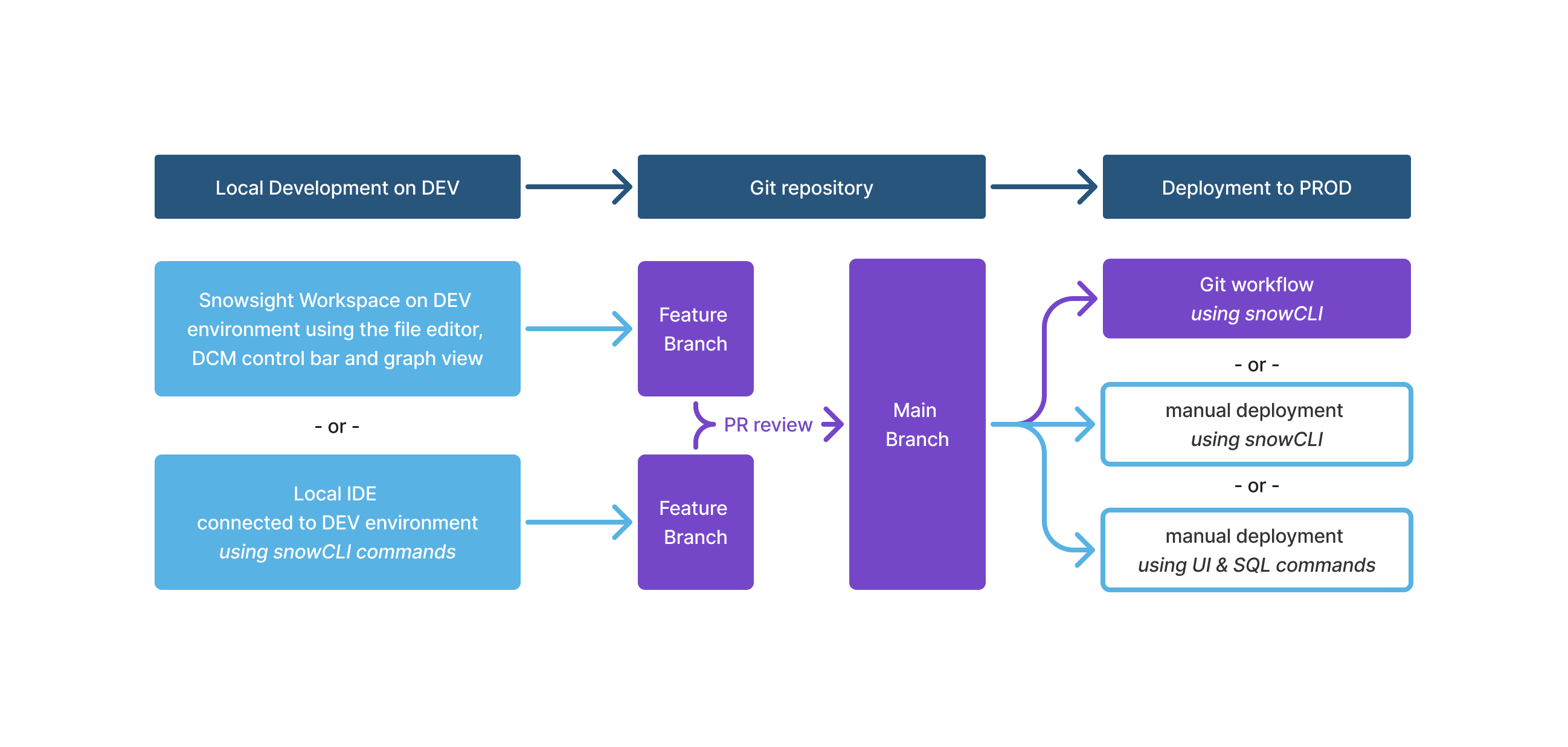

DCM interfaces across the development-to-production workflow

Cortex Code for DCM Projects

Cortex Code is an agentic AI tool for Snowflake. With the DCM skill enabled, Cortex Code can autonomously create, migrate, debug, and deploy DCM Projects. It can also work alongside you step by step. The DCM skill is available in any Cortex Code environment, including Cortex Code CLI, Cortex Code in Snowsight, the Snowflake extension for VS Code, and Cortex Code Desktop.

The Cortex Code DCM skill enables the following:

  • Scaffold a new DCM project from scratch, including the manifest file, the folder structure, and definition files.
  • Author and edit DEFINE statements, Jinja templates, and macros.
  • Run PLAN, DEPLOY, TEST, and PREVIEW commands.
  • Interpret plan output, diagnose failures, and suggest fixes.
  • Download and inspect deployment artifacts.
  • Navigate and explain an existing DCM project.

To get started with the Cortex Code DCM skill, use one of the following options:

  • Snowsight Workspaces: Open Cortex Code in the Workspaces sidebar while editing your project files, as described in Cortex Code in Snowsight.
  • Cortex Code CLI: Install Cortex Code CLI as described in Installing Cortex Code, then start Cortex Code in your terminal.
  • VS Code extension: Use the Snowflake extension for VS Code to work with Cortex Code directly from your editor.
  • Cortex Code Desktop: Run Cortex Code as a standalone desktop application connected to your Snowflake account. See Cortex Code Desktop.

In any of these interfaces, use the $dcm skill reference or the term DCM in your natural language prompt.

For example:

  • “Create a new DCM project for our analytics pipeline”
  • “Plan my project against the PROD target”
  • “Why did my last plan fail?”
  • “Add a new dynamic table definition for customer spending”

Snowflake CLI for DCM Projects

Snowflake CLI is a command-line interface for Snowflake. It is a tool that you can use to interact with your Snowflake account from your local IDE.

  1. DCM Projects require Snowflake CLI version 3.24.0 or higher for the commands and options documented in this guide. Install or upgrade Snowflake CLI as described in Installing Snowflake CLI.

  2. Configure your connection to your Snowflake account, as described in Configuring Snowflake CLI and connecting to Snowflake. Confirm you have a working connection:

    snow connection test


    For more information about how the CLI resolves project targets separately from the active connection and role, see Project identifier resolution.

  3. Navigate to the local directory of your Git repository clone. For example:

    cd ./Quickstarts/DCM_Quickstart_1

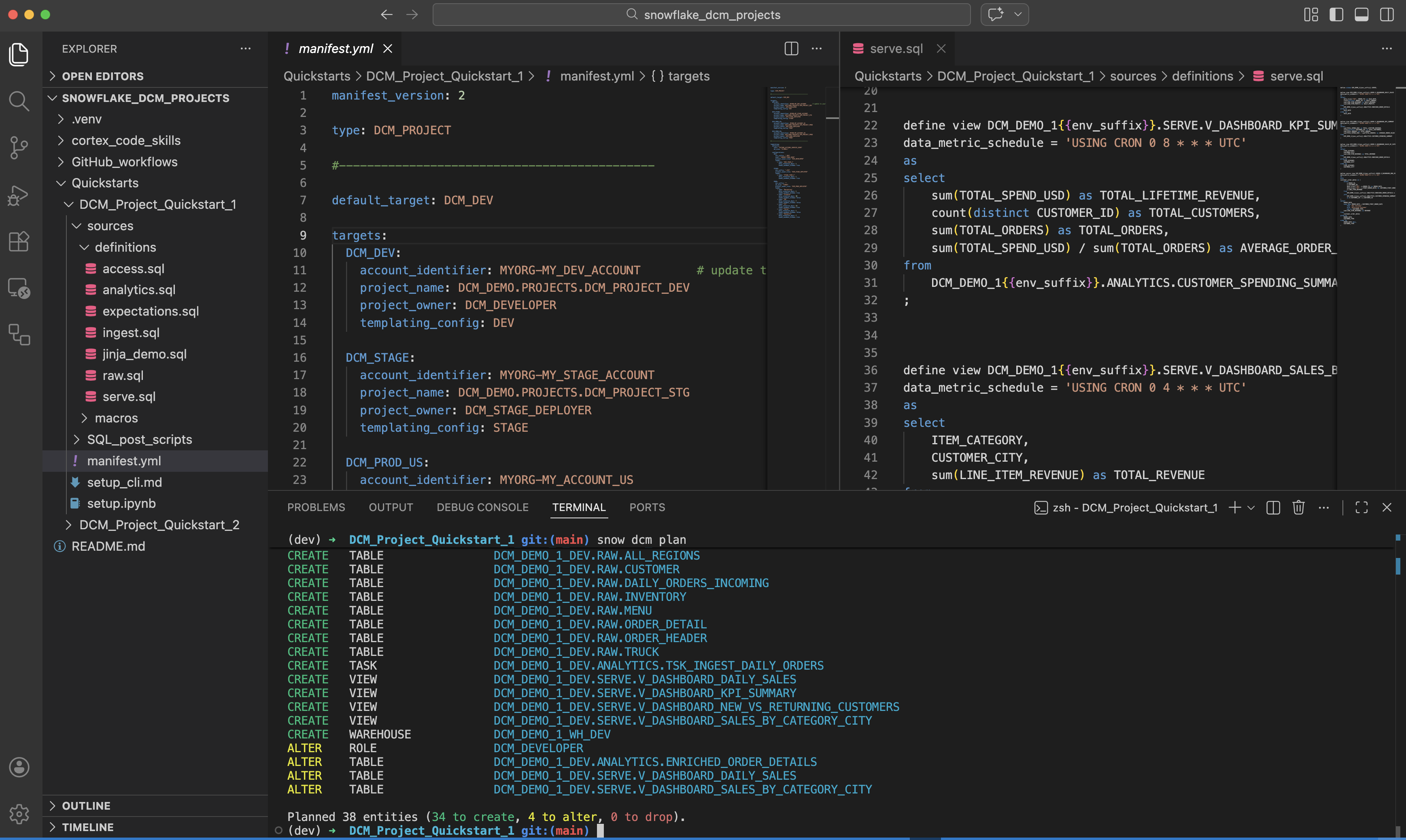

  4. See the Snowflake CLI DCM commands available to you:

    snow dcm --help


Git integration

Connect to the Git repository where your DCM project definition files are stored.

  1. Create a new workspace from a Git repository.

  2. Create or select a Git branch for your planned changes.

    Snowflake clones files from that branch into your workspace editor.

  3. Navigate to the folder where you have your DCM project definition files or want to create them.

Create a DCM project

Required roles and privileges

The role of the user who creates a DCM project object must have the following roles and privileges:

  • The CREATE DCM PROJECT ON SCHEMA privilege:
    GRANT CREATE DCM PROJECT ON SCHEMA <schema_name> TO ROLE <role_name>;


Create a DCM project

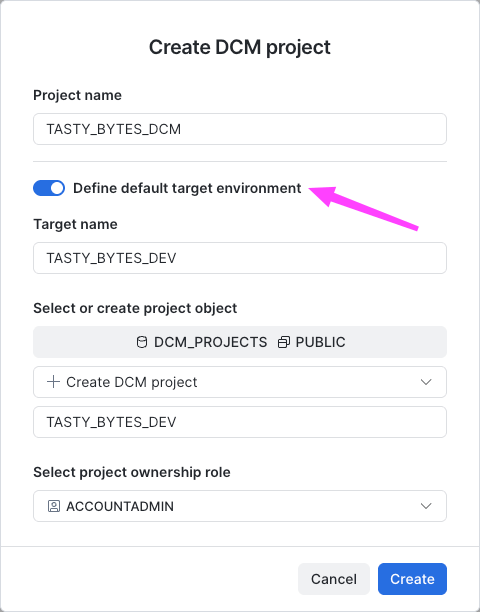

Create a DCM project object by using one of the following options.

CREATE [OR REPLACE] DCM PROJECT [IF NOT EXISTS] <my_project>
[COMMENT = 'my comment'];

Access control and role privileges

You can set role-based access control (RBAC) of the schema-level DCM project object to READ, MONITOR, PLAN, or OWNERSHIP privileges.

The privileges form a hierarchy in the order READ, MONITOR, PLAN, OWNERSHIP. Each privilege includes all operations of the privileges before it.

These privileges are independent of the access control for definition files stored in a workspace, stage, or repository.

PrivilegeDescriptionAllowed operations
READ
  • Shows if the DCM project object exists.
  • Lists the objects and grants deployed by the DCM project, which are visible to the user’s role.

This means you need both READ on the DCM project and the appropriate privilege to see each managed object. The underlying privilege varies by object type.

  • SHOW DCM PROJECTS LIKE ‘%project’
  • DESCRIBE DCM PROJECT <project>
  • SHOW ENTITIES IN DCM PROJECT <project>
MONITOR
  • Gives access to the complete deployment history, including all artifacts.
  • Gives the role the ability to analyze, debug, or audit production deployments without the ability to deploy changes directly.
  • All READ privileges
  • DESCRIBE DCM PROJECT <project> (with source and deployment path of latest deployment)
  • INFORMATION_SCHEMA.DCM_DEPLOYMENT_HISTORY (project_name => ‘db.schema.project’)
  • SHOW DEPLOYMENTS IN DCM PROJECT <project>
  • LIST all files in the deployment
  • GET any access to files inside the DCM project
PLAN
  • Gives the role the ability to validate definition changes with a dry run without the ability to deploy them.
  • PLAN runs with the privileges of the DCM project owner role. See PLAN privilege.
  • All MONITOR privileges
  • EXECUTE DCM PROJECT <project> PLAN
  • EXECUTE DCM PROJECT <project> PLAN DELTA
OWNERSHIP
  • The role that is used to create the DCM project object is the owner of that project.
  • Gives the role the ability to deploy changes.
  • Gives the role the ability to transfer ownership of the project to another role when the project has not yet been deployed.
  • All PLAN privileges
  • EXECUTE DCM PROJECT <project> DEPLOY
  • EXECUTE DCM PROJECT <project> PREVIEW
  • EXECUTE DCM PROJECT <project> TEST
  • DROP DCM PROJECT <project>
  • ALTER DCM PROJECT <project>
  • GRANT READ on DCM PROJECT <project> TO ROLE <role2>
  • GRANT MONITOR on DCM PROJECT <project> TO ROLE <role2>
  • GRANT PLAN on DCM PROJECT <project> TO ROLE <role2>

PLAN privilege

The PLAN privilege lets a role run EXECUTE DCM PROJECT ... PLAN and EXECUTE DCM PROJECT ... PLAN DELTA without holding OWNERSHIP of the DCM project. PLAN includes all MONITOR and READ operations. This is useful for CI/CD pipelines and developer roles that need to validate definition changes before deployment but shouldn’t be able to apply those changes to the account.

To grant the PLAN privilege, run the following command with the DCM project owner role:

GRANT PLAN ON DCM PROJECT <project_name> TO ROLE <role_name>;

Note

Snowsight Workspaces doesn’t support the PLAN privilege yet. In Workspaces, DCM Projects operations always attempt to run with the DCM project owner role, regardless of the user’s current or default role. To run PLAN with a role that holds only the PLAN privilege, use SQL or Snowflake CLI.

Warning

PLAN runs with the privileges of the DCM project owner role, not with the privileges of the role that holds PLAN. All privileges needed to simulate the creation or modification of objects come from the owner role. As a result, a role with PLAN can validate changes that it couldn’t make with its own privileges.

The plan output contains a changeset for every entity defined in the project files supplied to the PLAN command. For every existing object in the changeset, the output includes the object’s current metadata, such as view queries, stored procedure and function bodies, and policy expressions. A role with PLAN can supply project files that include DEFINE statements for any object the owner role can read, and then retrieve that object’s DDL from the plan output, even if the role can’t access the object with its own privileges.

The plan output contains object metadata (DDL). It doesn’t contain the data stored in these objects.

Grant PLAN only to roles that you trust with the metadata of every object that the DCM project owner role can read.

Ownership on DCM-managed objects

The role that deploys a DCM project, by default, has the OWNERSHIP privilege of all deployed objects.

Project definitions can transfer ownership to other roles. To prevent owner lockout, the DCM project owner role must hold the role that receives ownership. For the complete definition pattern and its limitations, see OWNERSHIP grants.

DCM PLAN and DEPLOY actively check for potential owner lockout and fail before making any changes if a GRANT OWNERSHIP statement on a managed object points to a role that the project owner role doesn’t hold. This is a safety check, not a side effect: DCM prevents the lockout from happening in the first place.

The situation where the project owner is already locked out of a managed object only occurs when a privilege was revoked from the project owner role manually outside of DCM. In that case, the next PLAN or DEPLOY will fail because the current state no longer matches what DCM expects. To recover, restore the required ownership or role hierarchy outside of DCM.

For an intentional management handoff, first use the documented unmanage workflow with a role that has the required privileges, and then remove the definition before redeploying. Removing a definition without first detaching the object expresses intent to drop the managed object; it isn’t a recovery method for owner lockout.

You can start managing an object that another role already owns. The DCM project owner role must hold that role, and the project definitions must include the object definition. Deployments can then change the object while ownership stays with that role. Snowflake recommends adding a GRANT OWNERSHIP statement that grants ownership of the object to the same role, so the definitions stay in sync with the current ownership.

If the DCM project owner role already owns the object, add the object definition to the project. Ownership stays with the DCM project owner role.

Define a DCM project

A DCM project is based on a manifest file and one or more SQL object definition files. These files are typically stored and managed in a Git repository or your local workspace.

  • The manifest file

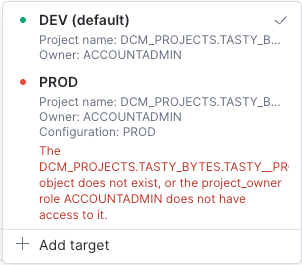

    • Specifies one or more target environments with corresponding account identifiers, DCM project objects, owner roles for these objects, and optional templating configurations
    • Optionally, specifies templating defaults and one or more configurations with values for template variables.
  • The object definition files

    • Define a group of Snowflake objects, grants, and expectations that you want to manage together in this DCM project.

See Create a DCM project folder to store your definition files for how to set up a DCM project folder and the definition files and how to use templates to define your DCM project.

Plan a DCM project

Planning a DCM project performs a dry run to preview changes before deployment. Snowflake compares your project definition files to existing objects and shows which objects will be created, altered, or dropped. No changes are made to your account.

Use planning to review and validate changes before deploying a DCM project. You can specify options such as a configuration or an output path for plan results.

The PLAN mimics the DEPLOY command as much as possible, except it doesn’t actually execute any DDL statements. To run PLAN, a role needs the PLAN or OWNERSHIP privilege on the DCM project. In both cases, PLAN runs with the privileges of the DCM project owner role, the same role that DEPLOY uses. This way, a dry run surfaces privilege errors before deployment. For more information, see PLAN privilege.

Important

Always run the PLAN command on your projects before deployment to help ensure there are no errors from syntax, templating, object dependency, access privileges, and so on. Review the plan output to debug any errors, preview the rendered Jinja with the provided variables, and preview the changes that will be made once you deploy.

The plan performs the following steps:

  1. Renders all Jinja templating with the selected configuration profile or values provided at runtime.
  2. Compares all definitions against the current state of entities that were defined as part of the last deployment.
  3. Converts all defined statements into CREATE, ALTER, DROP, GRANT, and REVOKE statements.
  4. Sorts all statements based on their interdependencies.
  5. Compiles all statements.

Note

Although PLAN catches almost all possible errors that can occur during deployment, it does not guarantee a successful deployment.

Run the PLAN command

The PLAN command takes the following information as input:

  • The path to the manifest file

    The CLI reads the target from the manifest (default_target or --target flag). For SQL commands, the path to the manifest file and the project name must be provided.

  • Defined values for Jinja variables (optional).

  • The target’s templating_config automatically selects the configuration profile. For SQL commands, use the USING CONFIGURATION clause to specify the profile.

  • One or more values of the configuration profile to overwrite (optional).

The following are examples of how to run the PLAN command.

Run the snow dcm plan command in your local IDE terminal or as part of a Git workflow.

An example of a CLI command to plan a DCM project from a local directory is:

cd ./Quickstarts/DCM_Project_Quickstart_1/
snow dcm plan

An example of a CLI command to plan a DCM project from local files by using a non-default target is:

snow dcm plan --target PROD_US --save-output

An example of a CLI command to plan a DCM project with optional arguments is:

snow dcm plan \
  --variable "wh_size='MEDIUM'" --variable "teams = ['TEAM_A', 'TEAM_B']" \
  --save-output

Variables must be enclosed in double quotes, with additional single quotes for string values. Lists of values require square brackets.

Snowflake CLI commands

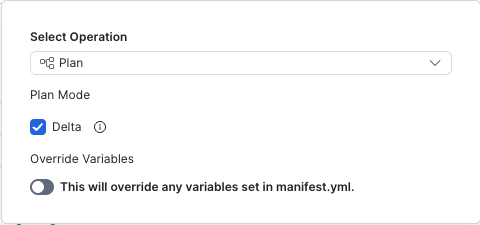

Plan only changed definitions (PLAN DELTA)

PLAN DELTA is a faster variant of PLAN for validating incremental changes to an existing project. Instead of checking all definitions against the current account state, PLAN DELTA only evaluates the definitions you changed and any downstream definitions in the project that depend on them.

Use PLAN DELTA during active development to get faster feedback on your edits. Because it skips unchanged definitions, it doesn’t detect changes that happened outside of DCM Projects on your account since the last deployment (for example, a view dropped or altered by another user). Always run a full PLAN before deploying to ensure no external changes will cause a deployment failure.

snow dcm plan --delta

Definition file path

You have the following options to reference the location of the manifest and definition files.

  • From a Workspace path

    The Snowsight user interface automatically lists all DCM project definitions inside the current workspace. You can select one of these paths and workspaces will use it to run DCM commands.

    If you want to manually run SQL commands in workspaces, you can also refer to that same path inside any of your workspaces.

    Tip: The 3-dot menu next to every file in your workspace lets you copy the full path to that file into your SQL code.

    An example of a SQL command to plan a DCM project from a workspace path is:

    EXECUTE DCM PROJECT DCM_PROJECT_DEV
      PLAN
      USING CONFIGURATION DEV
    FROM
      'snow://workspace/USER$.PUBLIC.DEFAULT$/versions/live/Quickstarts/DCM_Project_Quickstart_1';

  • From a local Git repository clone on your disk

    Select the directory that contains your manifest.yml file before running the CLI command in your local IDE. Alternatively, you can specify a different local directory that contains the manifest and definitions you want to use.

    An example of a CLI command to plan a DCM project from the current directory of a local Git repo:

    cd ./Quickstarts/DCM_Project_Quickstart_1/

    snow dcm plan

    snow dcm plan --target PROD


    An example of a CLI command to plan a DCM project from a different directory in a local Git repo clone:

    snow dcm plan DCM_PROJECT_DEV \
      --target DEV \
      --from ./Quickstarts/DCM_Project_Quickstart_2/

  • From your remote repository in a workflow

    The same CLI syntax can be used when the DCM commands are executed in a CI/CD workflow. You can call the CLI directly or use the reusable GitHub Actions from the snowflake-labs DCM repository, which handle CLI setup, authentication, and DCM commands internally.

    An example using the reusable dcm-plan action:

    jobs:
      plan:
        runs-on: ubuntu-latest
        environment: PROD
        permissions:
          contents: read
          id-token: write
        steps:
          - uses: actions/checkout@v7
          - uses: snowflakedb/snowflake-actions/dcm/plan@v3
            with:
              target: PROD
              project-path: Quickstarts/DCM_Project_Quickstart_1/
              snowflake-user: ${{ env.SNOWFLAKE_USER }}

  • From a Stage or Git repository clone in Snowflake

    If you want to run a PROCEDURE or TASK inside Snowflake that runs DCM commands, this SQL command can reference an absolute path to a Snowflake stage or Git repository clone inside the account.

    For Git repository clones, consider first running ALTER GIT REPOSITORY FETCH to get the latest version.

    '@...' paths can only be used when executing DCM SQL commands.

    An example of a SQL command to plan a DCM project from a Stage or Git repository clone in Snowflake is:

    EXECUTE DCM PROJECT DCM_PROJECT_DEV
      PLAN
      USING CONFIGURATION DEV
    FROM
      '@DCM_DEMO.DEPLOY.DCM_DEMO/branches/main/Quickstarts/DCM_Project_Quickstart_1/';


Plan output

For the PLAN and DEPLOY output format, including the JSON schema and examples, see the PLAN and DEPLOY output section of the EXECUTE DCM PROJECT command reference.

Deploy a DCM project

When you deploy a DCM project, the following actions are performed:

  • Objects that are defined but don’t exist yet are created.
  • Objects that already exist but differ from the current definition are altered.
  • Objects that already exist as defined are skipped.
  • Objects that already exist but are no longer defined are dropped.

The same behavior applies to grants and attached data quality expectations defined in the project.

Important

To avoid any unintended data loss, always run and review your PLAN output before running DEPLOY.

Each DCM project can only have one instance deployed at any time. Multiple configuration profiles can’t coexist. Deploying configuration B with the same DCM project will drop any objects from other previous configurations that are not defined in B.

Create one DCM project for each target environment. The DCM project for each environment can then point to the same definition files, but deploy independently with different values for each variable, like suffix => 'DEV_JS', so that they can exist independently side-by-side on the same Snowflake account.

You can overwrite values for selected variables at runtime if you want to use a pre-defined profile with a slight variation.

For example:

EXECUTE DCM PROJECT DCM_DEMO.PROJECTS.DCM_PROJECT_DEV
  DEPLOY
  USING CONFIGURATION DEV (suffix=>'DEV_USER', user=>'JANEDOE')
FROM
  'snow://workspace/USER$.PUBLIC.DEFAULT$/versions/live/Quickstarts/DCM_Project_Quickstart_1';
snow dcm deploy DCM_PROJECT_DEV \
  --target DEV \
  --variable "suffix='DEV_USER'" \
  --variable "user='JANEDOE'"

Each deployment attempt (executing, successful, failed, or canceled) has a deployment number, for example DEPLOYMENT$1. Optionally you can specify a unique string as a deployment alias to name individual deployments for better observability in the deployment history. Think of the deployment alias like a commit message for your code change.

Each DEPLOY command first runs an internal COMPILE and PLAN as part of the deployment. If the PLAN succeeds, DEPLOY is executed directly afterwards. There is no option to intercept or review this internal plan step. The PLAN is executed to further reduce the risk of failure during the deployment. DEPLOY reconciles the submitted definitions with the current account state and computes a fresh changeset. It doesn’t replay a previously saved PLAN result. Intervening account changes can therefore change the deployment changeset even when the submitted definitions are unchanged. If DEPLOY fails, you can see in the error message if it failed during the RENDER, COMPILE, PLAN or DEPLOY step. Failure during any step before DEPLOY step is similar to PLAN: No DDL changes are executed.

Warning

In the rare case of failure during the DEPLOY step, the defined changes can be partially executed. This can potentially cause some of the managed objects to be in an undefined state. In most cases, fixing the root cause and executing DEPLOY again restores the defined target state. To apply an earlier definition state through a new reconciliation, see Recover an earlier defined state.

The target path for the DEPLOY output file can’t be customized. Deployment artifacts are always stored inside the DCM project.

Run the DEPLOY command

To execute the DEPLOY command, provide the following inputs:

  • The path to the manifest file.
  • A configuration profile must be named if configuration profiles are defined in the manifest.
  • Optionally, values for the configuration profile overriding the default values.
  • Optionally, a deployment alias.

The following are examples of how to run the DEPLOY command.

EXECUTE DCM PROJECT DCM_DEMO.PROJECTS.DCM_PROJECT_DEV
  DEPLOY
FROM
  'snow://workspace/USER$.PUBLIC.DEFAULT$/versions/live/Quickstarts/DCM_Project_Quickstart_1';

An example of a SQL command to deploy a DCM project when using Jinja with configuration profiles but overwriting wh_size and teams is:

EXECUTE DCM PROJECT DCM_DEMO.PROJECTS.DCM_PROJECT_DEV
  DEPLOY AS "testing 2 teams"
  USING CONFIGURATION DEV (wh_size => 'MEDIUM', teams => ['TEAM_A', 'TEAM_B'])
FROM
  'snow://workspace/USER$.PUBLIC.DEFAULT$/versions/live/Quickstarts/DCM_Project_Quickstart_1';

See PLAN and DEPLOY output for the standard plan output structure.

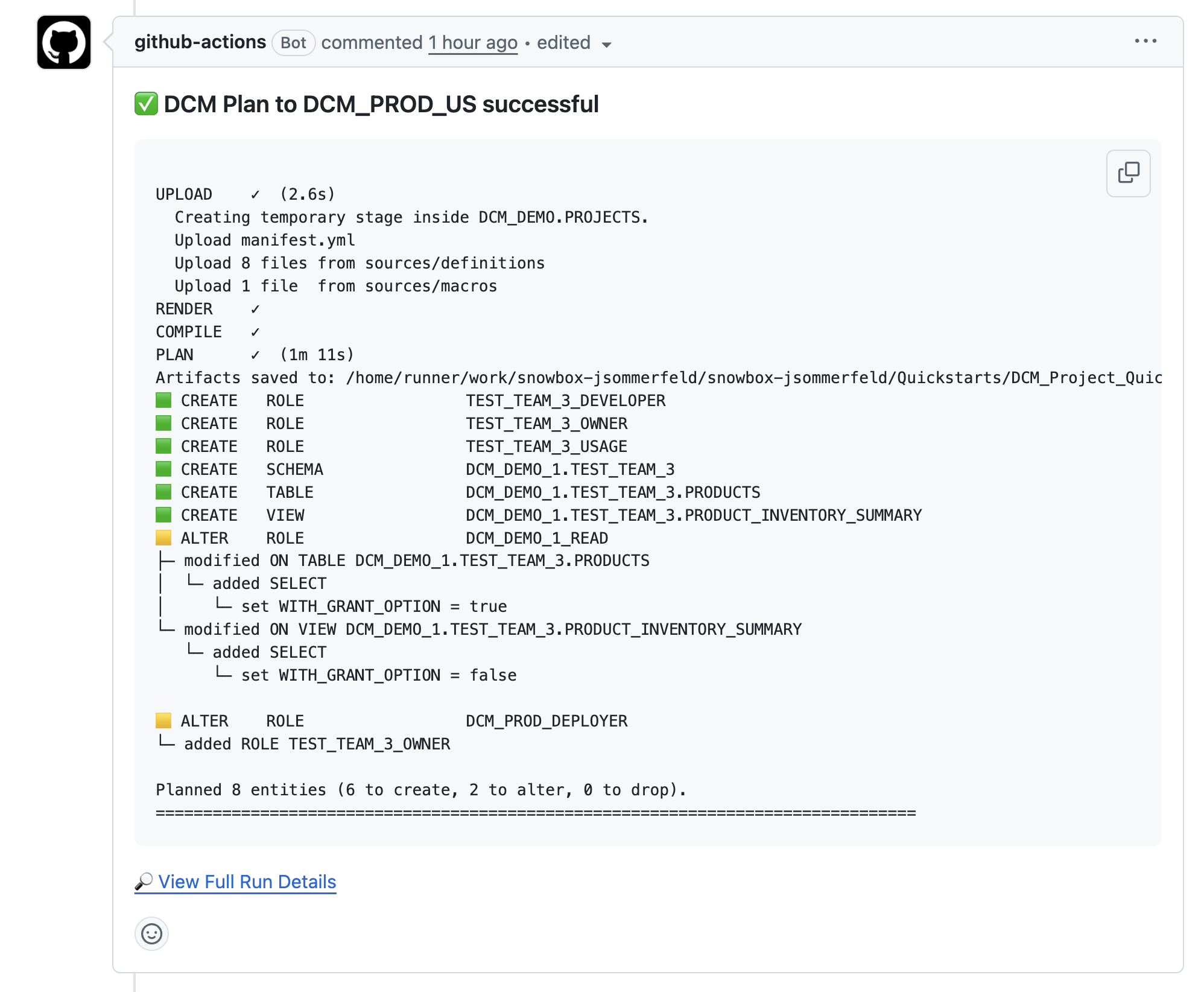

Automate a DCM project deployment

To set up collaboration workflows and automate PLAN and DEPLOY with CI/CD pipelines, see Collaboration and CI/CD for DCM Projects.
